We are using GitHub Projects for our project management (see Tools Used for access details). This page provides a guide on it’s setup and best practices for adding new tasks.
Resources
- Our initial GitHub Projects setup was inspired by the video series [Scrum with Github Projects](https://youtube.com/playlist?list=PLGxFXI4dC2siB2ENZ6OhagfwSId5FcWmY&si=LyZADQK-y4O0dWGC)
- For understanding Scrum and the Agile methodology Atlassian’s no-nonsense guide to Agile was a valuable resource
- See also the lecture/workshop slides and L2-agile.pdf and W3-sprint-planning.pdf
Hierarchy of Work Items
We use three levels of work items to organise and track progress. Each level helps break down the project into smaller more manageable parts:
- Epic - A large body of work that represents a major feature, them, or deliverable. May be completed over multiple sprints.
- Requirement - A specific piece of functionality or capability needed to deliver part of an Epic
- Task - The smallest unit of work. Tasks are concrete, actionable steps that team members can pick up during a sprint.
Together, they form the following hierarchy:
On GitHub Projects
On GitHub Projects the tag
field specifies whether a item is an Epic, Requirement or Task.

There are three filtered views
for each type. Each view is configured with specific fields with varying levels of details tailored to the type of work item it summarises.
It’s important to note that GitHub Projects is built on top of GitHub Issues. Because of this, every item must be linked to an issue and a repository. So, to achieve the hierarchy of work items illustrated above, sub-issues are used. For example, a Requirement item will be a parent issue for for several Task items and itself a sub-issue of an Epic.
How we use User Stories
What are User Stories?
A user story is an informal, general explanation of a software feature written from the perspective of the end user. Its purpose is to articulate how a software feature will provide value to the customer. User stories give the team important context and associate tasks with the value those tasks bring.
As a (type of user), I want to (do something specific) so that (I achieve some outcome).
They should also include acceptance criteria. Read more here: Atlassian - User Stories
Some Agile resources (such as Atlassian’s guide) use the term User Story in place of what we call a Requirement.
We’ve chosen to use Requirement instead because this project is broader than just software development. As a university project, our deliverables include not only code but also documentation, progress checklists, and presentations. These don’t always map cleanly to the idea of a “user story,” but they can still be captured as requirements that contribute to the overall project outcome.
So, where do we use user stories? In general, user stories help describe Task-level work items that are software related. On GitHub projects, the description
section of an Task item should include the relevant user story.
Multiple user stories make up a requirement. To see our breakdown of user stories into requirements check out our Breakdown of Reqs.
Other Pages

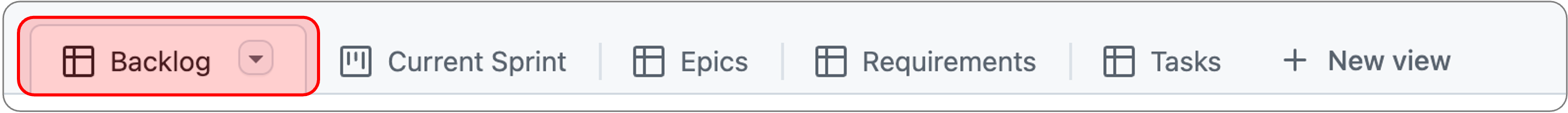

Backlog
The Backlog is the central collection of all work items - Epics, Requirements, and Tasks. New items are added here whenever they arise. During Sprint Planning (like W4 - Sprint Planning), the team selects which items to bring into the upcoming sprint, and at that point their Priority and Estimate values are reviewed and confirmed.

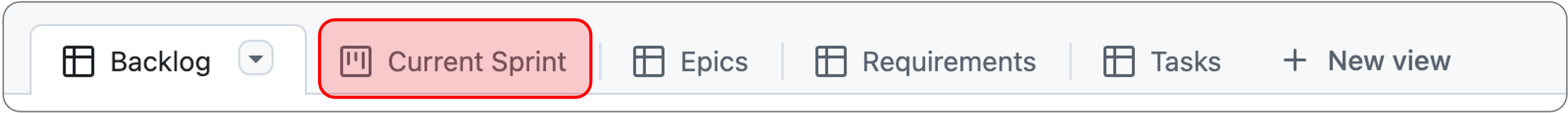

Current Sprint
The Current Sprint view uses a Kanban-style board to track progress. It is filtered to show only Tasks, since these are the actionable units of work. The board is further filtered to include only the Tasks assigned to the active sprint, as agreed during Sprint Planning.
Fields
Some fields in GitHub Projects need clarification on how we use them.
Status
Every Task has a status that reflects its current stage in the workflow:
- To Do – The item has not been started.
- In Progress – Work on the item is actively underway.
- Under Review – The item is awaiting review (e.g., code review, documentation check).
- Done – The item has been completed.
Statuses are updated throughout the sprint to provide a clear picture of progress and to keep the Kanban board accurate.
Priority
Every Task is assigned a priority. We use a simple three-level system:
- P0 - Highest priority
- P1 - Medium priority
- P2 - Lowest priority
Priorities are reviewed and confirmed during sprint planning to ensure the team is focused on the most important work.
Estimate
Instead of using “story points,” we estimate effort using the Fibonacci sequence, where the number corresponds to the expected duration of a Task in hours (e.g., 1, 2, 3, 5, 8).
This approach makes estimates easier to interpret and has the added benefit that GitHub Projects can automatically sum the estimates of all Tasks within a Requirement, giving an overall time estimate for that Requirement.
Estimates are decided as a team during sprint planning.
